Analyze the AI-driven data center boom reshaping infrastructure investment. Get insights on hyperscale demand, power bottlenecks, and emerging opportunities.
Artificial intelligence is no longer a software story - it’s infrastructure. From GPTs to humanoid robotics, every leap in capability rides on compute; compute, in turn, demands something physical: power, cooling, chips, and space. At the heart of it all lies the data center - the new industrial hub of the global economy. Once seen as passive storage, it is now a multi-sector, capital-intensive, power-hungry megastructure reshaping real estate, utilities, manufacturing, and the grid.
This piece synthesizes leading research (Morgan Stanley, McKinsey, CBRE), proprietary financial models, and our prior work (“Data Center Market 2030” and “Datacenter Trends to 2026”) to map the financial and industrial ecosystem powering AI’s physical buildout and to offer an investor’s playbook for underwriting it.

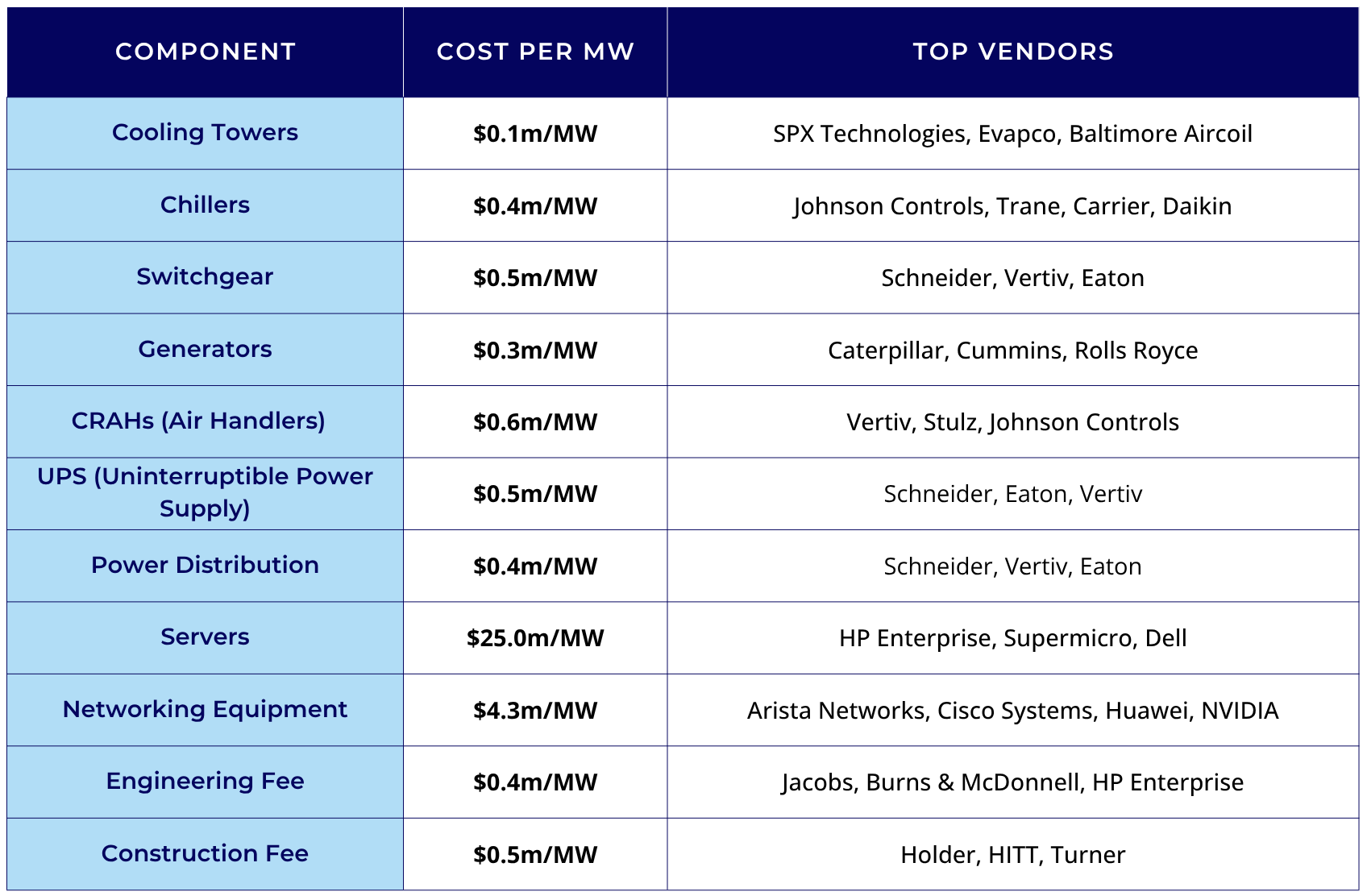

Think in megawatts (MW), not square feet. A modern hyperscale site is a bill of materials wrapped in a schedule. Below is a concise per-MW view of core components and representative vendors useful for capex modeling and vendor diligence.

Why this matters: Servers dominate absolute dollars, but electrical and thermal systems dictate whether dense AI racks actually deliver rated performance and uptime. Those “supporting” categories punch above their weight in both schedule risk and margin leverage.
AI’s impact on infrastructure has hit escape velocity. In 2025, AI workloads consumed 13% of total data center compute. That’s projected to double to 28% by 2027. And it's not just model training anymore - it’s real-time inference at scale. Hyperscalers (Amazon, Microsoft, Google, Meta) are embedding AI into every workflow, product, and process.
This is driving a $345 bn. hyperscaler capex wave in 2025 alone, with spending growing at a 19% CAGR through 2029. Nvidia’s data center revenue surged 73% YoY. Meta alone raised its 2025 capex guidance to $64–72 bn. For every delayed project, three more appear.
The semiconductor layer is the engine room. Over 1 million 8-GPU server units are expected to be deployed globally by 2026, needing more than 12 million chips. Nvidia still leads, but AMD, Intel, and in-house silicon like Amazon’s Trainium or Google’s TPU are gaining share.
Contract manufacturers like Supermicro, Quanta, Foxconn, and Wiwynn are essential nodes in this chain - operating fabs across Taiwan, Vietnam, and California. The shift to real-time AI inference requires custom server racks, denser power loads, and liquid-cooled designs.
This is triggering a semiconductor capex flywheel that could top $1 tn. through 2028, largely secured via backlog commitments and hardware roadmaps. Hardware is no longer commoditized - it’s the bottleneck.
Data centers consumed about 2% of global electricity in 2024. By 2035, that could rise beyond 10%. In the US, AI data centers are responsible for half of the 1% annual load growth through the decade.
In Ireland, data centers now consume 25% of grid capacity, triggering moratoriums. In Virginia and Silicon Valley, grid approvals are taking 5–10 years. According to Schneider Electric’s 2025 survey, 44% of operators now report utility wait times exceeding 4 years, forcing a rethink in power procurement.
Time-to-power is now a competitive advantage. A 1-year lead in power delivery equates to $3 - 4 million per MW in value, surpassing many plant construction costs.
The power plant side now has asymmetric upside. Gas-fired redevelopment at Homer City (4.5 GW) is expected to cut emissions by 60–65% per MWh. In Europe, replacing coal with clean gas and nuclear is key to unlocking AI infrastructure.
AI servers generate heat loads 3–5x traditional cloud setups. By 2027, rack densities will exceed 176 kW, up from 162 kW in 2024. Air cooling is hitting its limits.
Liquid cooling and immersion systems are being scaled by Daikin, Carrier, IBM, and Schneider. Startups in Europe and Asia are delivering containerized immersion units. According to industry surveys, 62% of operators now factor in thermal optimization during initial design.
This changes the HVAC opportunity:
These players are now reporting record order books, driven by AI-specific data centers.
In 2025, US data center construction is expected to hit $28 bn. - 36% of all private non-residential spending. By 2030, that share may exceed 10%. This isn’t speculative buildout; it’s hyperscaler-backed, demand-secured infrastructure.
REITs and infrastructure platforms are adapting:
Lead times for critical components—turbines, switchgear, cooling sit between 100–150 weeks. Supply chain resilience is now a core investment factor. Pre-fab modules and vertical integration are emerging themes.
Electricity is the backbone of digital infrastructure, yet grid systems are strained and lagging. The U.S. alone has a 2,500 GW interconnection queue — nearly 20x current demand. The average data center grid approval now takes 5–10 years, particularly in high-demand zones like Northern Virginia and California.
Key challenges:
As a result, hyperscalers are entering joint ventures with utilities to de-risk power procurement. Some are even funding their own substations and transmission lines. In Europe, sovereign cloud mandates are clashing with green energy limits. Ireland’s cap on new data center connections is a cautionary tale.
Utilities are no longer defensive, regulated plays - they are emerging as AI infrastructure catalysts.
AI’s carbon footprint is real. According to Morgan Stanley, data centers will contribute 215 million tons of CO₂ by 2030, equivalent to 0.6% of total global emissions. The push for clean compute is no longer just regulatory - it’s strategic.
The Green Reliability Premium (GRP) - the cost of securing 24/7 carbon-free energy is now $40/MWh, projected to rise to $48/MWh post-2026 as U.S. tax credits decline. Hyperscalers are absorbing these costs because the alternative is project delay... or reputational damage.
ESG-Linked Capex Trends:
This shift creates new pricing power for clean power providers - especially those offering firm baseload like hydro and nuclear. Regions with low-carbon grids are gaining competitive advantages in attracting AI infrastructure.
Global investors must factor in regional readiness - not just hyperscaler demand - when evaluating infrastructure equities and REITs.

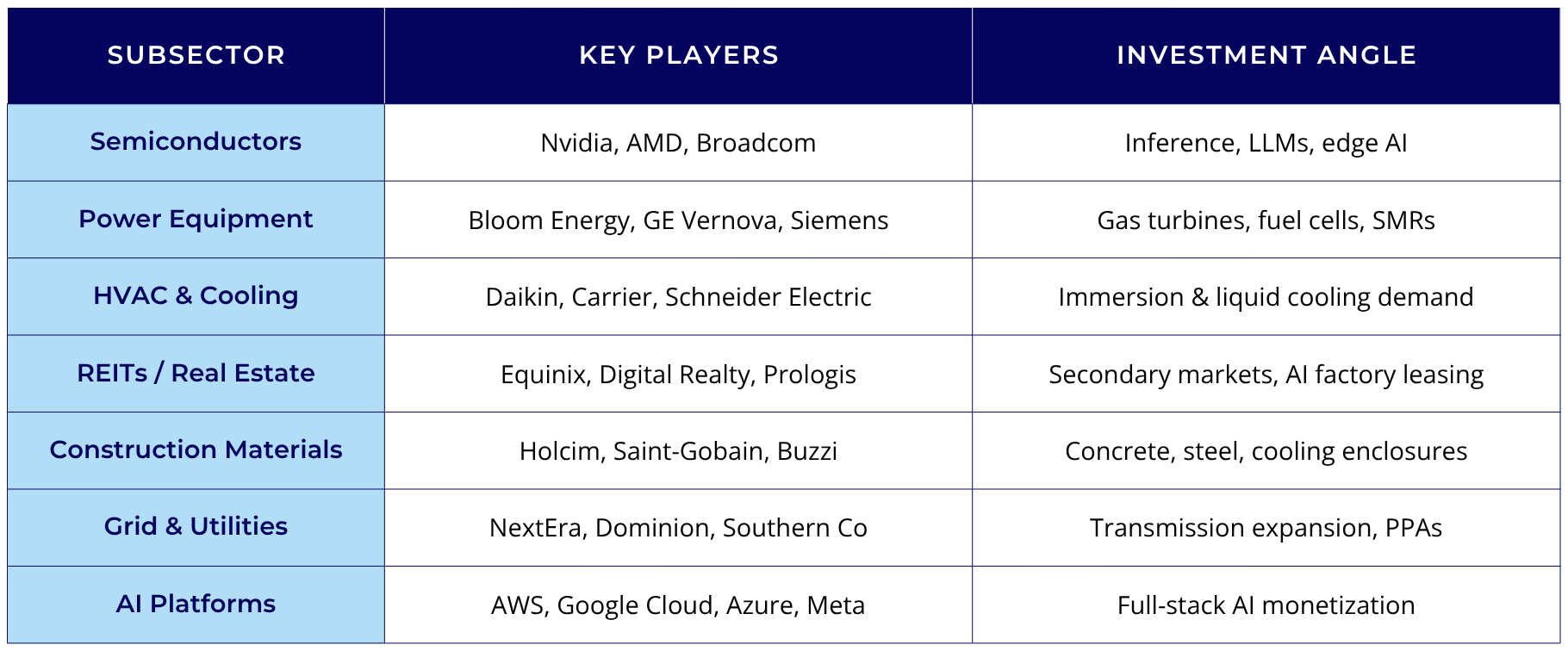

Data centers are no longer just a REIT or cloud play. They touch semiconductors, power, HVAC, utilities, real estate, and materials. Here's how the opportunity map looks:
.png)
Traditional valuation models often miss the value embedded in “time-to-power” arbitrage. According to Morgan Stanley:
“The value of a 1-year time advantage is $3–4 million per megawatt, often exceeding total power plant capex.”
This is why Bitcoin-to-AI conversions have become attractive despite operational complexity. In recent deals, power premia exceeded 300% - but still made sense from the AI operator’s perspective due to lost inference revenue from delay.
Strategic Investors Should Consider:
Risks and Headwinds (With Practical Mitigants)
AI is no longer a horizontal tool - it’s a vertically integrated infrastructure play. From silicon to substations, liquid cooling to low-carbon baseloads, data centers are the factories of intelligence.
This is a new industrial age… and the most capital-intensive one since the internet’s birth. Investors and operators who understand where the bottlenecks lie, who controls the inputs, and how power dynamics shift, will create long-term alpha.
